Why Delaying Custom Bag Orders to Avoid Peak Season Often Extends Lead Time

BagWorks Malaysia
18 January 2025

In our production planning operations, we observe a recurring pattern where corporate buyers delay reusable bag orders to avoid peak manufacturing seasons, particularly the Chinese New Year period that affects Malaysian businesses sourcing from overseas suppliers. The logic appears sound on surface evaluation: place orders after factory operations normalize to secure faster turnaround and avoid holiday-related disruptions. However, this timing strategy consistently produces the opposite result—extended lead times that exceed what buyers would have experienced had they committed during the peak season itself with appropriate buffer planning.

The misjudgment stems from a fundamental misunderstanding of how production capacity allocation operates in contract manufacturing environments. Buyers focus on the holiday shutdown period—typically one to two weeks in mid-February—and assume that placing orders immediately after this window will restore normal production timelines. What they fail to recognize is that factories do not operate on a first-come-first-served basis during recovery periods. Production slots for post-holiday delivery are allocated months in advance, and the capacity booking window closes well before the actual holiday begins.

From a production floor perspective, the Chinese New Year shutdown is not an isolated event but rather the culmination of a months-long capacity management process. Factories begin locking in production schedules for Q1 deliveries as early as October and November of the preceding year. By mid-December, most facilities have stopped accepting new orders for pre-CNY and immediate post-CNY production. This six-to-eight-week advance closure is not arbitrary—it reflects the operational realities of material sourcing, workforce planning, and existing order commitments that must be fulfilled before the holiday break.

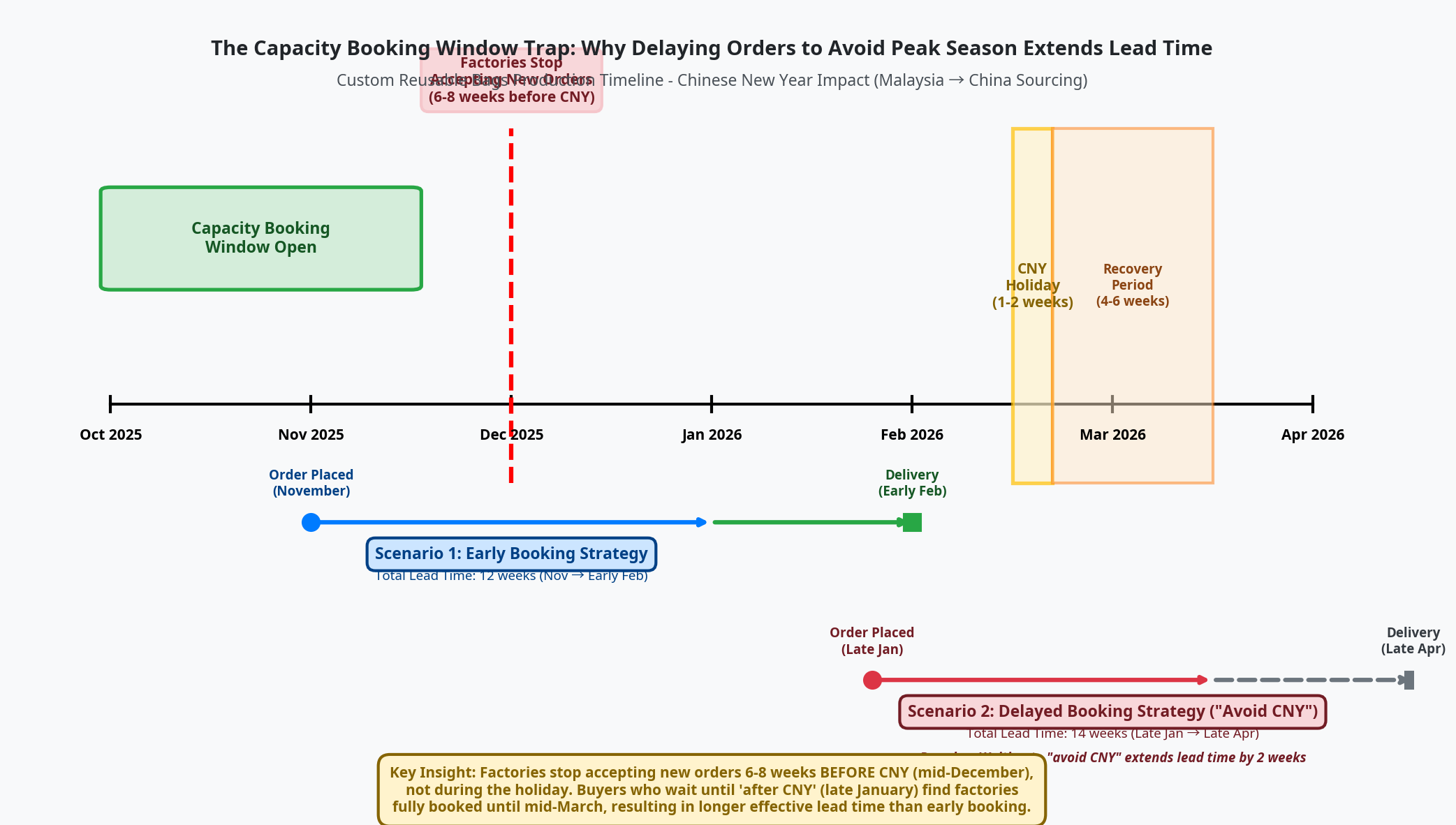

Capacity booking window comparison showing early booking vs delayed booking strategies for custom reusable bags production during Chinese New Year period

Consider the practical sequence that unfolds when a Malaysian buyer delays their custom tote bag order from November to late January, intending to place it "after CNY planning is complete." In November, when the buyer is still evaluating options, the factory is already sourcing fabrics, scheduling printing runs, and allocating production line time for orders that will ship in late February and early March. The buyer's assumption that they can secure a March delivery by ordering in late January fails to account for the fact that March production slots were filled in November and December. When the buyer finally commits in late January—just two weeks before CNY—the earliest available production window is not March, but mid-to-late April, after the factory works through its backlog of pre-holiday commitments and post-holiday recovery orders.

This creates a paradox where the buyer's attempt to avoid a two-week holiday disruption results in a ten-to-fourteen-week effective lead time, measured from their decision point to actual delivery. Had they placed the same order in November with explicit acknowledgment of the CNY buffer period, their bags would have been produced in late January and delivered in early February—well ahead of their target timeline and at standard pricing without rush fees or air freight premiums.

The capacity booking window operates on a different timeline than the production calendar that buyers typically reference when evaluating lead times. Standard production timelines for custom reusable bags—thirty-five to sixty days for semi-custom designs, sixty to ninety days for full custom development—assume that production begins immediately upon order confirmation. However, during peak season planning periods, "order confirmation" does not trigger immediate production commencement. Instead, it secures a position in the production queue that may be weeks or months away, depending on when the order was placed relative to the capacity booking deadline.

Malaysian businesses face particular exposure to this timing trap because their procurement cycles often align poorly with Chinese manufacturing capacity windows. Many companies finalize their promotional bag requirements in December and January, coinciding with budget approvals and marketing campaign planning for the upcoming quarter. This decision timeline places them squarely in the period when Chinese factories have already closed their order books for Q1 production. The result is that buyers who believe they are planning "three months ahead" of their April delivery target are actually competing for production capacity that was allocated four to five months prior.

The situation compounds when buyers attempt to accelerate timelines through premium pricing or supplier relationship leverage. Factories operating at full capacity during peak seasons cannot meaningfully compress lead times without displacing existing orders, which creates reputational and contractual risks that most suppliers will not accept regardless of price premiums. The occasional success stories where buyers secure rush production during peak periods typically involve either cancellations from other clients or suppliers accepting orders they cannot reliably fulfill, leading to quality compromises or further delays when production issues emerge.

From a production planning standpoint, the optimal approach for buyers is to decouple their order placement timing from their desired delivery date and instead anchor it to the capacity booking window relevant to their target production period. For deliveries required in March or April, this means placing orders in October or November, not in January or February. The counterintuitive aspect of this strategy is that it requires buyers to commit to specifications and quantities at a point when their internal planning may still be fluid, creating organizational resistance to early commitment.

However, the alternative—delaying orders until internal certainty is achieved—consistently produces worse outcomes in the form of extended lead times, reduced supplier options, and higher costs. Buyers who wait for "perfect information" before placing orders discover that the cost of certainty is measured in weeks of additional lead time and thousands of ringgit in expedited fees. The production floor does not reward perfectionism; it rewards early commitment backed by reasonable flexibility mechanisms such as quantity adjustment clauses or staged production releases.

The capacity dynamics extend beyond Chinese New Year to other predictable peak periods, including the year-end holiday season when Western markets drive demand surges, and the back-to-school period that affects promotional product suppliers. In each case, the pattern repeats: buyers who delay orders to avoid peak season congestion find themselves competing for post-peak capacity that was allocated during the peak period itself. The lesson is not that buyers should ignore peak seasons, but rather that they should recognize peak seasons as capacity booking deadlines rather than production disruption periods.

For businesses sourcing custom reusable bags from overseas suppliers, the practical implication is that lead time planning must account for two distinct timelines: the production timeline that measures actual manufacturing duration, and the capacity booking timeline that determines when production can begin. Conflating these two timelines—assuming that a sixty-day production cycle means orders can be placed sixty days before the required delivery date—is where the misjudgment occurs. The reality is that during peak planning periods, the capacity booking timeline adds an additional six to twelve weeks to the effective lead time, and this extension is not visible in standard lead time quotations that assume immediate production commencement.

Buyers who recognize this distinction and adjust their procurement timing accordingly gain significant advantages in supplier selection, pricing stability, and delivery reliability. Those who continue to optimize around production timelines while ignoring capacity booking windows will continue to experience the paradox of extended lead times despite their attempts to avoid peak season disruptions. The production floor operates on capacity allocation logic, not calendar logic, and buyers who align their timing strategies with this reality consistently achieve better outcomes than those who rely on surface-level holiday avoidance tactics.

Understanding how production timelines interact with capacity booking windows requires buyers to shift from reactive timing strategies—placing orders when internal planning is complete—to proactive capacity management that treats supplier production slots as finite resources requiring advance reservation. This shift in perspective transforms lead time from a passive constraint into an active planning variable, enabling businesses to secure optimal delivery timelines even during periods of high demand and constrained supplier capacity.
