Corporate Gift Procurement Quality Inspection Timing Trap: Why an 80% PSI is Already Too Late

When assisting companies with their annual corporate gift procurement planning, one of the most common quality control failures isn't due to suppliers intentionally cutting corners. Instead, it stems from the buyer setting the quality inspection point at the Pre-Shipment Inspection (PSI) stage—that is, when 80% of the production is already complete, 4,000 finished products are off the line, all raw materials have been committed, and the production methods are locked in. When the procurement department first discovers at this stage that the fabric thickness, stitching density, or printing resolution of the actual products significantly deviates from the approved sample from three months ago, the entire project is already at an impasse: accept a compromise on quality to meet the deadline for Chinese New Year or Hari Raya, or reject the shipment and absorb RM 50,000 to RM 150,000 in sunk costs, a 6 to 8-week delay for remanufacturing, and the double loss of import duties and sales tax.
This scenario repeatedly occurs in cross-border procurement for Malaysian companies, but the root of the problem lies not in the supplier's integrity or capability, but in a systemic misjudgment by the buyer regarding the 'timing of quality inspection.' Most companies, after approving a sample, assume that 'production quality will be consistent with the sample' and delegate the entire responsibility of quality verification to the single checkpoint of Pre-Shipment Inspection. This assumption overlooks a fact considered common knowledge in manufacturing: the material sources, production equipment, operators, quality control standards, and even the factory's production schedule priorities for the sample stage can be completely different from those of the mass production stage.
Samples are typically handcrafted by experienced sample makers using high-spec materials specifically prepared for samples, and are completed under the direct supervision of a quality manager. But when the order enters mass production, the operators on the production line might be handling this style for the first time, the materials used are sourced from different batches, the quality control personnel's attention is divided among five different client orders running simultaneously, and the factory's scheduling pressure may lead to certain quality check steps being simplified or skipped. This is not a moral issue; it is the structural reality of scaled production.
When a buyer sets the quality inspection point at 80% production completion, the decision appears logical on the surface: 'Inspect after most products are finished to confirm the quality of the entire batch at once.' But from a quality management perspective, this timing choice is effectively a surrender of all quality control leverage. When an inspector opens the cartons in the factory warehouse and finds that the actual fabric weight is 240 GSM instead of the sample's 280 GSM, the stitching density is 10 stitches per inch instead of the sample's 14, and the print color saturation is noticeably lower than the approved Pantone color, the following critical remedial opportunities have all been lost:

All raw materials have been procured and committed to production. If the fabric weight is insufficient, the factory cannot replace the material without re-procurement, which means a 3 to 4-week lead time for materials, an additional RM 30,000 to RM 50,000 in material costs, and a contractual dispute with the raw material supplier (who will argue that the material they supplied met the factory's order specifications, not the buyer's sample specifications from three months prior).
Production methods and equipment settings are already fixed. If the stitching density is insufficient, it usually means the factory adjusted the sewing machine speed settings or changed to a larger stitch length head to increase production efficiency. To revert to the sample stage settings after 80% of production is complete would require not only recalibrating all equipment but also retraining operators, a process that could take 1 to 2 weeks and would affect the factory's other concurrent client orders, leading the factory to demand that the buyer bear the costs of production line downtime.
4,000 finished products are already completed and packaged. Even if the buyer insists on a remake, the factory will argue that the material costs, labor costs, equipment depreciation, and warehousing fees for these 4,000 units should be borne by the buyer, because 'the buyer did not explicitly request a first-article inspection or in-process inspection before production began.' This cost is typically between RM 50,000 and RM 80,000, and it does not include the additional time cost required for remanufacturing.
The event deadline is only 3 to 4 weeks away. For corporate gifts procured from China or Vietnam, sea freight time is typically 2 to 3 weeks, customs clearance is 3 to 5 days, and inland transport and distribution take another 3 to 5 days. If the goods are rejected at the PSI stage and a remake is requested, even if the factory immediately begins remanufacturing and agrees to air freight (which costs 5 to 8 times more than sea freight, an additional RM 15,000 to RM 25,000), the buyer will not receive the goods before the Chinese New Year or Hari Raya event deadline. This means the entire corporate gift project fails, and the HR or marketing department will have to explain to management why the year's most important client relationship-building activity could not proceed as planned.
In this dilemma, most buyers ultimately choose to accept the quality compromise and internally classify the experience as 'unstable supplier quality' or 'this factory is unreliable.' But in reality, the root of the problem is that the buyer relinquished the initiative in quality control during the project planning phase. When the quality inspection point is set at 80% production completion, the buyer is effectively telling the supplier: 'You can complete this order any way you want, I will only check the result at the end.' And the supplier, when faced with multiple client orders, limited production resources, and constant cost pressure, will naturally prioritize allocating resources to clients who continuously monitor quality throughout the production process.

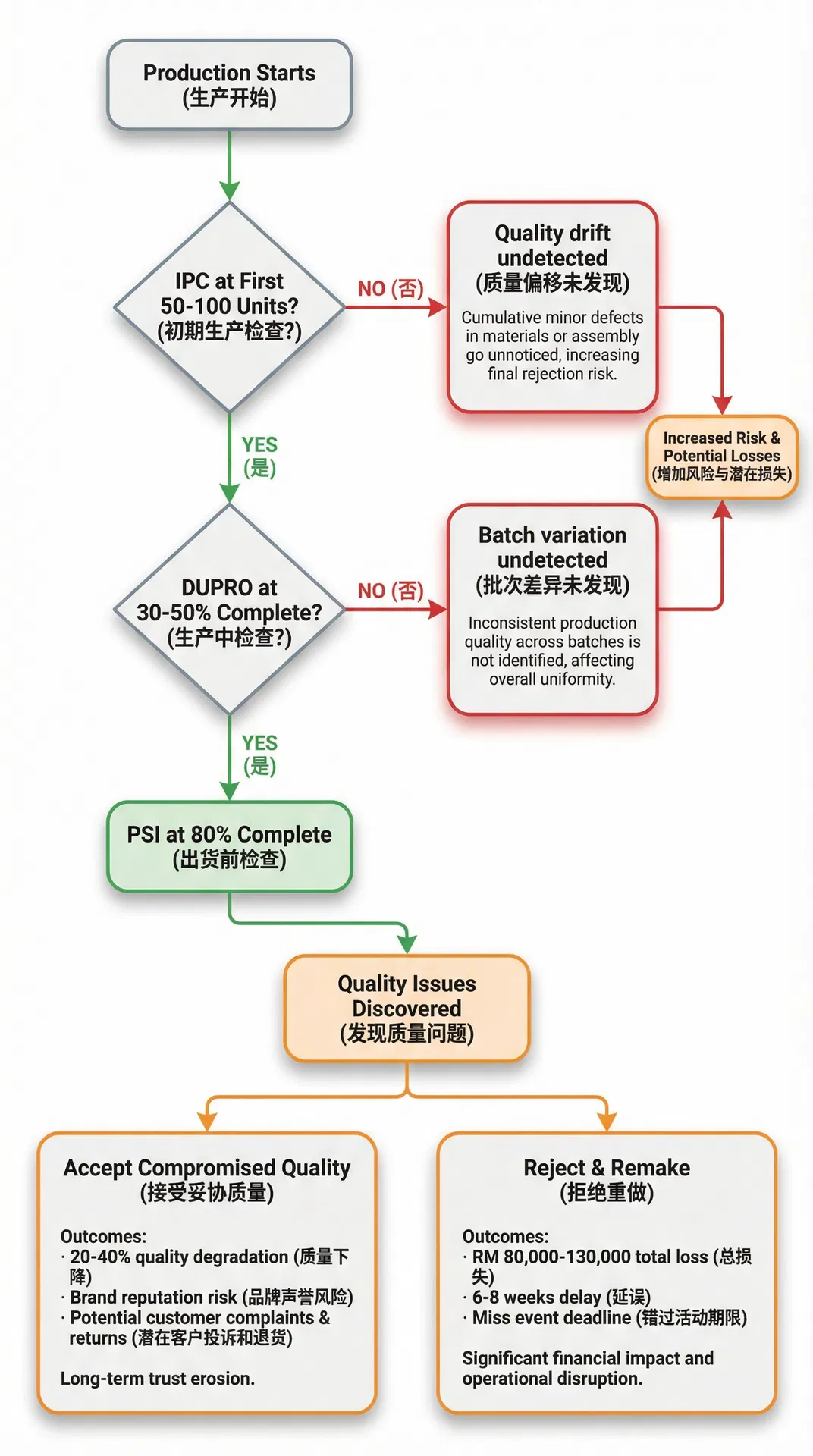

From a professional quality management perspective, effective quality control must be based on 'process supervision' rather than 'result inspection.' This means quality inspection points should be set at three key nodes: Initial Production Check (IPC), During Production Check (DUPRO), and Pre-Shipment Inspection (PSI). The function and purpose of each node are completely different, yet most buyers mistakenly believe that PSI can replace the functions of the first two nodes.
An Initial Production Check should be conducted immediately after the production line has completed the first 50 to 100 finished products. The purpose of this stage is not to check the 'quality of the entire batch,' but to verify that 'the production line setup is correct.' The inspector needs to confirm: are the materials used by the factory consistent with the sample (fabric weight, color, texture), are the production equipment parameters correct (stitching density, printing resolution, heat-press temperature), and do the operators understand the quality standards (which defects are acceptable, which must be reworked). If problems are found at this stage, the remedial cost is typically only RM 3,000 to RM 8,000 (recalibrating equipment, replacing some materials, retraining operators), and it will not affect the overall delivery schedule.
An In-Process Inspection should be conducted when production progress reaches 30% to 50%. The purpose of this stage is to monitor 'quality stability.' Even if the initial inspection passes, after 1 to 2 weeks of continuous operation, the production line may still experience quality drift: operators simplifying certain steps to increase efficiency, a material supplier changing a batch mid-production, or equipment parameters shifting slightly due to prolonged operation. If these issues are discovered at the 30% to 50% stage, the buyer still has enough time to request adjustments from the factory, and the factory has sufficient motivation to cooperate (because the remaining 50% to 70% of production is not yet complete, making the cost of adjustment relatively low).

Pre-Shipment Inspection is the final 'result confirmation.' Ideally, if both the initial and in-process inspections have been conducted and passed, the PSI stage should be a routine spot check to confirm details like packaging, labeling, quantity, and shipping documents are correct. But if the buyer skips the first two stages and conducts the first quality check directly at the PSI stage, then PSI transforms from a 'routine confirmation' into a 'final gamble'—and the odds of this gamble are extremely unfavorable for the buyer.
In the context of corporate gift procurement in Malaysia, this misjudgment of inspection timing is further amplified by several local factors. First is the cost of import taxes. When a buyer rejects goods at the PSI stage and requests a return shipment, the import duties (6% to 10%) and Sales and Service Tax (SST, currently 6% to 10%) that have already been paid are often not fully refundable, or the refund process takes 3 to 6 months. This means that while rejecting the goods, the buyer must also bear an additional 12% to 20% in tax-related sunk costs, which, for an order of 5,000 units at RM 25 per unit, amounts to an extra RM 15,000 to RM 25,000.
Second is the potential impact of the tropical climate on quality. PSI is usually conducted in the factory's warehouse or inspection room, where temperature and humidity are controlled. But when the shipment arrives in Malaysia after 2 to 3 weeks of sea transit, stays in a port warehouse for 3 to 5 days, and then undergoes inland transport and storage before finally being distributed to employees or clients in a high-temperature, high-humidity environment, certain quality issues that seemed 'acceptable' at the PSI stage can rapidly deteriorate: eco-friendly bags made of organic cotton may develop mold, the adhesive on laminated cooler bags may fail, and printing ink may fade due to high temperatures. These problems cannot be detected during the PSI stage in a factory environment. However, if the buyer had requested a 'tropical climate simulation test' during the initial inspection stage (placing a sample in a 35°C, 85% humidity environment for 72 hours), these potential issues could have been identified and prevented before production began.
Third is the event-driven nature of demand. Corporate gift procurement in Malaysia is typically tied to specific holidays or events: Chinese New Year (January-February), Hari Raya (follows the Islamic calendar, usually in April-May), company anniversaries, and year-end client appreciation events. The dates for these events are fixed and cannot be postponed due to supply chain issues. When a buyer discovers quality problems at the PSI stage and requests a remake, the consequence of 'missing the event deadline' is not just a project delay, but project failure—because a New Year's gift sent after Chinese New Year, or a festive gift sent after Hari Raya, has lost its core value as a 'corporate gift.'
For companies wishing to delve deeper into corporate gift selection strategies, it is advisable to start with a complete decision-making framework, systematically evaluating multiple dimensions such as quality standards, inspection timing, supplier capabilities, and contract terms. Inspection timing is just one variable in the overall procurement decision, but it is an often-underestimated variable with a decisive impact on the final outcome. When a buyer moves the inspection point from '80% production completion' forward to 'first article completion' and '30% completion,' they not only significantly reduce quality risks but also send a clear signal to the supplier: 'We value process quality, not just the final result.' And this signal is often more effective than any contract clause or penalty mechanism in ensuring the supplier maintains the required quality standards throughout the production process.
In practice, many buyers believe that adding initial and in-process inspections will increase procurement costs. This concern is reasonable on the surface: if each inspection requires dispatching an inspector to a factory in China or Vietnam, or commissioning a third-party inspection company for an on-site check, the cost per inspection is about USD 200 to USD 400 (approx. RM 900 to RM 1,800). The total cost for three inspections would be around RM 2,700 to RM 5,400. But this cost needs to be compared with the potential losses of discovering quality issues at the PSI stage: remake costs of RM 50,000 to RM 80,000, air freight fees of RM 15,000 to RM 25,000, tax sunk costs of RM 15,000 to RM 25,000, and the unquantifiable 'loss of client relationships due to project failure.' From a risk management perspective, the inspection cost of RM 2,700 to RM 5,400 is an extremely worthwhile insurance policy.
More importantly, once a buyer establishes a three-stage quality control mechanism of 'Initial Inspection + In-Process Inspection + Pre-Shipment Inspection,' suppliers will realize during the quotation stage that 'this client is serious about quality' and will allocate sufficient quality management resources in their production plan. This expectation effect is often more effective than post-hoc inspection and remediation because it changes the supplier's behavior pattern from the source. When suppliers know the buyer will inspect at the first-article stage, they will use materials and processes consistent with the sample during sampling and initial production, rather than waiting until the PSI stage to 'gamble on whether the buyer will notice.'
From a compliance and regulatory perspective, Malaysian companies procuring corporate gifts also need to consider whether the products meet local safety standards and labeling requirements. For example, if the gift is a food-contact item like a cooler bag or cutlery pouch, it needs to comply with the relevant regulations of the Malaysian Food Safety and Quality Division (MAFQ); if the gift is an electronic product (like a power bank or Bluetooth speaker), it needs to meet SIRIM certification requirements. These compliance checks often cannot be performed during the PSI stage, as PSI inspectors are typically responsible only for 'quality,' not 'compliance.' If the buyer requests the inspector to confirm the presence of necessary compliance markings (such as material composition labels, manufacturer information, importer information) during the initial inspection stage, these issues can be identified and corrected before production begins, preventing the entire shipment from being detained by customs during clearance.
Finally, from a holistic supply chain management perspective, the choice of quality inspection timing reflects the buyer's understanding of the balance between 'control' and 'trust.' Setting the inspection point at 80% production completion is effectively a 'low trust + low control' strategy: the buyer does not trust the supplier to maintain quality proactively but is unwilling to invest resources in supervision during the process, ultimately resorting to a one-time 'acceptance' check when production is nearly finished. The result of this strategy is often dissatisfaction for both buyer and supplier: the buyer feels the supplier's quality is unstable, and the supplier feels the buyer's requirements are unclear. In contrast, the three-stage mechanism of 'Initial Inspection + In-Process Inspection + Pre-Shipment Inspection' is a 'high trust + high control' strategy: the buyer trusts the supplier's ability to meet quality standards but simultaneously conducts supervision and confirmation at key nodes to ensure a mutual understanding of those standards. This strategy not only reduces quality risks but also builds a more stable, long-term supplier relationship.
When Malaysian companies shift their quality inspection point from '80% production completion' to 'first article completion' and '30% completion,' they are not just changing an operational procedure; they are redefining the risk structure of the entire procurement project. The cost of this change is limited (an additional RM 2,700 to RM 5,400 per project), but the potential losses it avoids are enormous (saving RM 80,000 to RM 130,000 in remedial costs per project). More importantly, it sends a clear message to the supplier: 'We value quality, we will monitor the process, and we expect you to meet the standard at every stage.' And this message is often more powerful than any contract clause or penalty mechanism in ensuring the final delivered corporate gifts truly align with the brand's image and client expectations.
You May Also Like

When Corporate Gift Budgets Collapse at the Last Mile: Malaysia's East-West Delivery Cost Trap
Enterprise procurement teams often finalize gift type selection before mapping delivery geography. In Malaysia, this sequence creates a structural cost problem that only surfaces at the logistics stage—and by then, the budget has already been approved.

When a Company Chooses 'Eco-Friendly' Bags as Gifts, Only to Find the Supplier's Green Claims Fail an ESG Audit: The Procurement Trap of Certification Labels
A supplier's 'eco-friendly' gift bags are often unable to meet ESG audit requirements for a GRS Transaction Certificate, and they can only produce a generic factory certification. This gap isn't because the supplier is dishonest, but because the procurement side never asked the right questions.
