How Long Does It Take to Produce Custom Reusable Bags in Malaysia?
How Long Does It Take to Produce Custom Reusable Bags in Malaysia?
Expert Quick Answer
Production lead times for custom reusable bags in Malaysia range from 7 days to 16 weeks, depending on customization level, supplier location, and order urgency. Local Malaysian suppliers typically deliver ready-stock customization in 7-14 days, while overseas suppliers require 35-60 days for semi-custom designs and 60-90 days for full custom development. Understanding these timelines—and the trade-offs between speed, cost, and customization depth—is essential for avoiding missed deadlines, excess inventory costs, and quality compromises.
Why Production Lead Time Is a Critical Decision Factor for Malaysian Businesses
In our experience working with Malaysian enterprises across retail, hospitality, and government sectors, production lead time is frequently underestimated until it becomes a crisis. A corporate event planner discovers their custom tote bags won't arrive until two weeks after their product launch. A retail chain commits to a promotional campaign without confirming supplier capacity during peak season. A government agency faces tender disqualification because their supplier cannot meet the mandatory delivery date.
These scenarios share a common root cause: treating lead time as an afterthought rather than a strategic constraint. Production timelines directly impact three dimensions of business risk. From a budget control perspective, rushed orders incur premium fees—air freight costs 5-6 times more than sea freight, and express production charges can add 30-50% to unit costs. From a brand reputation standpoint, late delivery of promotional bags forces businesses to either cancel campaigns (wasting marketing spend) or distribute generic alternatives (diluting brand impact). From a regulatory compliance angle, Malaysia's accelerating plastic bag ban timeline (Penang 2025, Perak 2026, national rollout by 2026) means businesses must secure compliant reusable bag suppliers well in advance, as demand surges will strain production capacity industry-wide.
The strategic question is not simply "how long does it take?" but rather "how do I match lead time requirements to my business constraints without overpaying or compromising quality?"
Understanding the Malaysia Reusable Bag Procurement Landscape
Malaysian businesses face a unique procurement environment shaped by both local supply capabilities and regional manufacturing dynamics. Local Malaysian suppliers—concentrated in Klang Valley, Penang, and Johor—excel at speed and flexibility. They maintain ready-stock inventories of standard bag styles (non-woven totes, canvas shoppers, RPET bags) and offer logo printing or heat transfer customization with 7-14 day turnaround. Communication is seamless (same time zone, Bahasa Malaysia/English fluency), site visits are practical for quality audits, and there are no import duties or complex customs procedures. However, local suppliers typically require higher minimum order quantities (MOQ 1,000-2,000 pieces) and charge 15-25% more per unit compared to overseas alternatives.
Overseas suppliers—primarily based in China (Guangzhou, Yiwu, Xiamen)—offer cost advantages and deeper customization capabilities. They can manufacture complex designs (multi-compartment bags, custom hardware, specialty fabrics) at lower unit costs, especially for bulk orders exceeding 5,000 pieces. However, lead times extend significantly: 14-21 days for sea freight to Malaysia, 3-5 days for customs clearance, and 30-45 days for production. The practical implication is that lead time strategy must align with customization depth and order urgency.

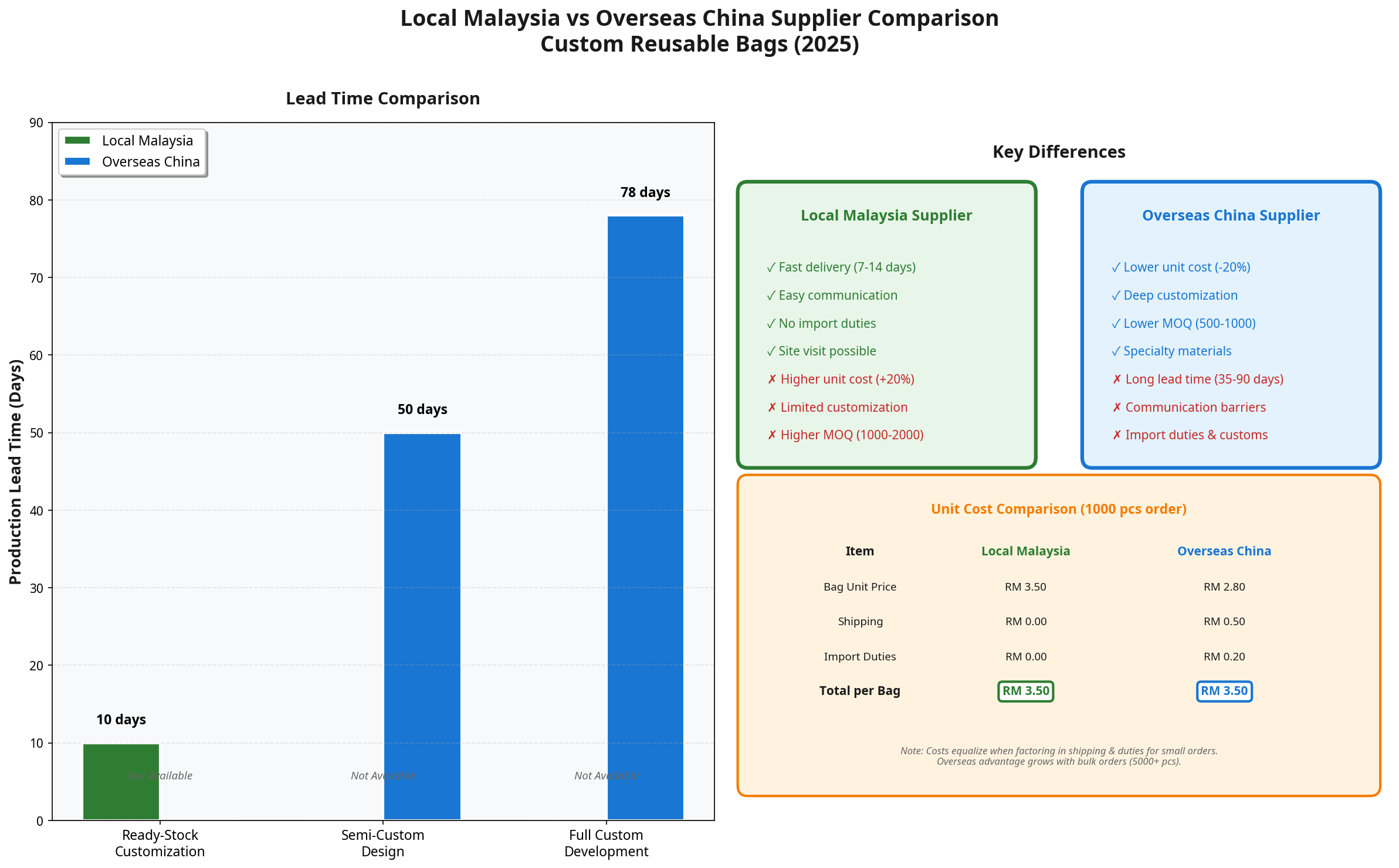

Figure 2: Local Malaysia vs Overseas China Supplier Comparison - Lead time, cost, and feature analysis for informed decision-making
The Three Production Pathways: Ready-Stock, Semi-Custom, and Full Custom
From a practical standpoint, custom reusable bag production follows three distinct pathways, each with different lead time profiles and trade-offs.
Ready-Stock Customization (7-14 Days)
This involves selecting from a supplier's existing bag inventory and adding your logo via screen printing, heat transfer, or embroidery. Local Malaysian suppliers typically complete this in 7-10 days (3 days for artwork approval, 2-3 days for printing setup, 2-4 days for production). The trade-off is limited design flexibility—you choose from standard sizes, colors, and materials rather than creating a unique bag shape. This pathway suits businesses with tight deadlines (corporate events, trade shows, seasonal promotions) where brand visibility matters more than product differentiation.
Semi-Custom Design (35-60 Days)
This allows moderate customization: selecting fabric type, adjusting bag dimensions, adding pockets or zippers, and choosing handle styles. The supplier modifies an existing base design rather than engineering from scratch. Overseas suppliers (typically China-based) dominate this segment. The timeline breaks down as follows: 7-10 days for design finalization, 14-21 days for material sourcing (standard fabrics like polyester or canvas are readily available; custom-dyed or recycled materials add 7-14 days), 15-20 days for production, and 14-21 days for sea freight and customs clearance to Malaysia. This pathway suits businesses balancing cost efficiency with moderate differentiation—retail chains launching private-label eco-bags or corporate buyers seeking branded bags with functional features.
Full Custom Development (60-90 Days)
This involves creating a completely new bag design from technical drawings. This includes prototyping (2-3 weeks for initial sample, plus 1-2 weeks per revision cycle), custom material sourcing (30-45 days for specialty fabrics like waterproof coatings, organic cotton, or biodegradable materials), production (20-30 days depending on complexity), and shipping (14-21 days). This pathway is reserved for businesses requiring unique product differentiation—luxury brands creating signature shopping bags, government agencies developing standardized bags for national campaigns, or enterprises launching new product lines where bag design is integral to brand identity.
The critical insight is that each pathway has a minimum lead time floor that cannot be compressed without incurring disproportionate costs. A business demanding a full custom bag in 4 weeks will either face rejection from reputable suppliers or pay 50-80% premium fees for expedited material sourcing and air freight—often resulting in quality compromises.

Figure 1: Custom Reusable Bag Production Timeline Comparison - Three pathways showing stage-by-stage breakdown from design to delivery
Key Factors That Extend or Compress Lead Times
Several operational variables determine whether your order lands at the shorter or longer end of the timeline range.
Material availability is the most common delay trigger. Standard materials (polyester, polypropylene non-woven, basic canvas) add minimal lead time. However, recycled PET (RPET) fabrics—increasingly demanded due to Malaysia's sustainability push—require 21-30 days for sourcing because fewer mills produce certified recycled materials. Organic cotton and biodegradable jute face similar constraints. Custom color dyeing adds 14-21 days because suppliers must batch-dye fabrics to your Pantone specifications. In practice, businesses can shave 2-3 weeks off lead times by accepting a supplier's existing color palette instead of insisting on exact brand color matches.
Customization complexity scales lead time non-linearly. Adding a simple logo via screen printing adds 2-3 days. Embroidery (which provides a premium look) adds 5-7 days due to digitization and slower stitching speeds. Multi-color designs require multiple printing passes, adding 1-2 days per additional color. Structural customizations—such as adding interior pockets, reinforced stitching, or custom zippers—add 7-14 days because they require production line reconfiguration and quality testing.
Seasonal bottlenecks are predictable yet frequently overlooked. Chinese suppliers face 3-4 week shutdowns during Chinese New Year (late January to mid-February), meaning orders placed in December may not ship until March. Malaysia's year-end corporate gifting season (November-December) strains local supplier capacity, extending lead times by 1-2 weeks. The mitigation strategy is straightforward: plan orders 6-8 weeks before known peak periods or accept premium pricing for priority production slots.
Decision Framework: Matching Lead Time to Business Scenarios
Rather than asking "what's the fastest option?", Malaysian businesses should ask "what's the optimal lead time strategy given my constraints?" The following framework maps common scenarios to appropriate production pathways.
| Scenario | Timeline | Recommended Pathway | Supplier Type | Key Trade-offs |
|---|---|---|---|---|
| Urgent Event (Hotel sustainability launch in 18 days) | <3 weeks | Ready-stock customization | Local Malaysia | Limited design options, higher unit cost (RM 3.50-5.00 vs RM 2.00-3.00), guaranteed delivery |
| Standard Campaign (Retail chain launching 50-store program in 6 weeks) | 3-8 weeks | Semi-custom design | Overseas (China) | Moderate customization, lower unit cost, requires advance planning |
| Strategic Launch (Government agency national compliance program) | 8-16 weeks | Full custom development | Overseas (China) | Complete design control, lowest unit cost for bulk orders (10,000+ pcs), longest lead time |
The underlying principle is that lead time compression always comes at a cost—either higher unit prices, reduced customization options, or elevated quality risks. Businesses that accept this reality and plan accordingly avoid panic-driven decisions that lead to overpayment or substandard products.
Risk Scenarios and Contingency Planning
Even with careful planning, lead time delays occur. The difference between businesses that absorb these disruptions and those that face operational crises lies in proactive contingency planning.
Sample rejection cycles are the most common delay trigger for custom orders. If your first prototype doesn't meet expectations—wrong fabric weight, incorrect logo placement, poor stitching quality—each revision cycle adds 2-3 weeks (1 week for supplier to produce revised sample, 1 week for international shipping, 3-5 days for your internal review). The mitigation strategy: provide detailed technical specifications upfront (fabric GSM weight, Pantone color codes, stitching standards) and request photo/video documentation before physical samples ship.
Material shortages have become more frequent post-pandemic. If your specified fabric is out of stock, suppliers may suggest alternatives—but this requires re-approval, adding 1-2 weeks. The contingency approach: pre-approve 2-3 alternative materials during the design phase, so suppliers can pivot without waiting for your decision.
Customs delays are rare but catastrophic when they occur. Malaysia's customs clearance typically takes 3-5 days, but shipments flagged for inspection (random checks or documentation errors) can be held for 1-2 weeks. The mitigation tactic: work with suppliers experienced in Malaysia exports who understand documentation requirements (Form D for ASEAN preferential tariffs, correct HS code classification).
Peak season congestion is predictable yet frequently ignored. If your order coincides with Chinese New Year, expect 3-4 weeks of additional delay. The planning rule: add 50% buffer time for orders during known peak periods, or schedule orders to arrive 4-6 weeks before critical deadlines.

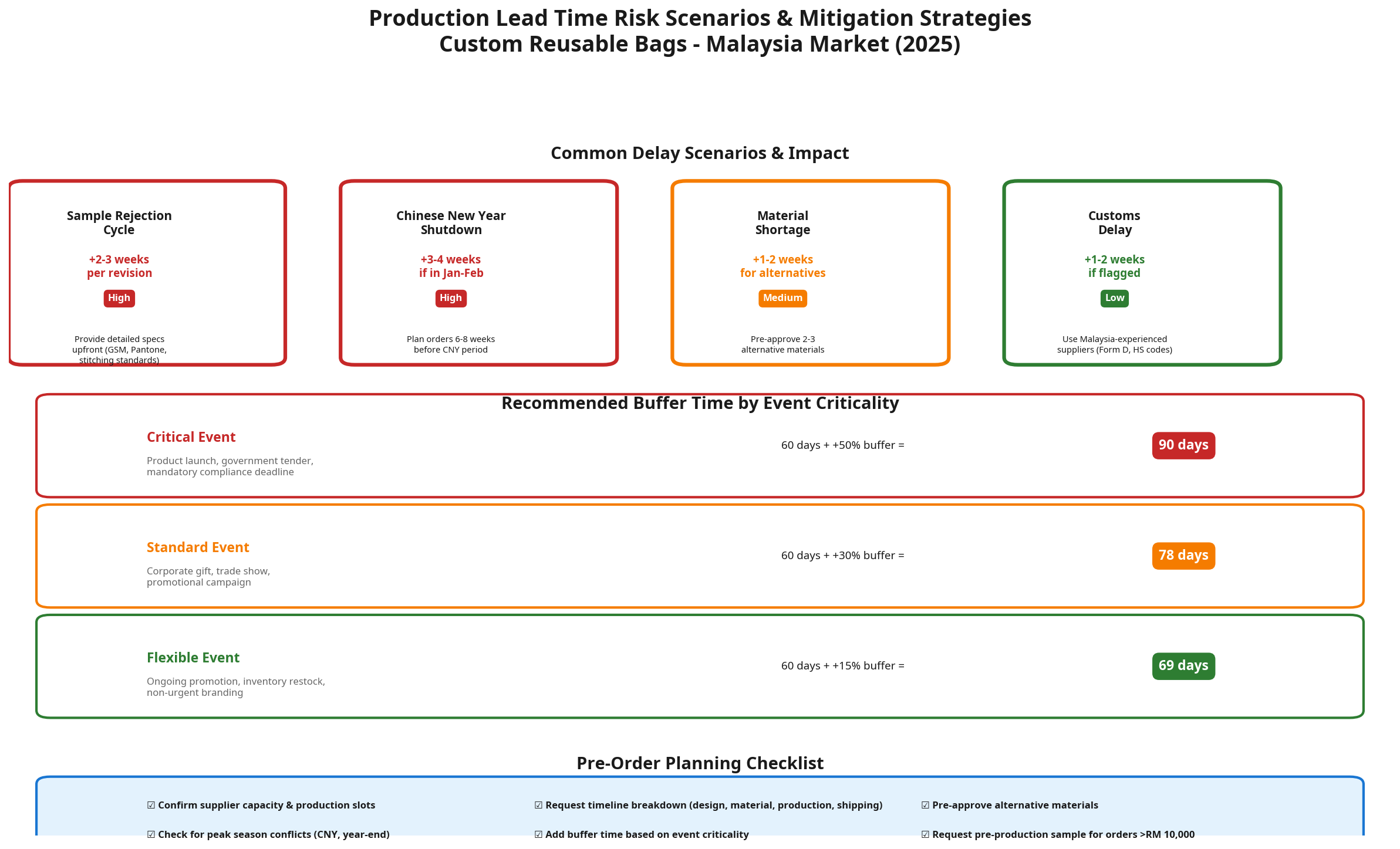

Figure 3: Production Lead Time Risk Scenarios & Mitigation Strategies - Common delay triggers, buffer time recommendations, and pre-order planning checklist
Practical Recommendations for Malaysian Businesses
Based on patterns we've observed across hundreds of procurement cycles, the following practices separate successful reusable bag programs from problematic ones.
Start planning 3x earlier than you think necessary. If your event is in 8 weeks, begin supplier discussions now—not in 6 weeks. This buffer absorbs sample revisions, material delays, and unexpected capacity constraints without forcing you into premium-priced rush orders.
Prioritize supplier reliability over unit cost for time-sensitive orders. A local supplier charging RM 4.50 per bag with a proven 10-day track record is a safer bet than an overseas supplier quoting RM 2.80 per bag but with uncertain delivery timelines. The RM 1.70 savings evaporates if late delivery forces you to air freight a replacement order at RM 8.00 per bag.
Request production timeline breakdowns, not just total lead time. Ask suppliers to itemize: artwork approval (X days), material sourcing (Y days), production (Z days), shipping (W days). This reveals whether their "30-day" quote assumes materials are already in stock (often unrealistic) or includes sourcing time (more credible).
Build relationships with both local and overseas suppliers. Use local suppliers for urgent, small-volume orders where speed trumps cost. Use overseas suppliers for planned, high-volume orders where cost efficiency matters. Maintaining dual sourcing options provides flexibility when circumstances change.
Common Questions About Reusable Bag Production Lead Times
How much does air freight reduce lead time compared to sea freight?
Air freight from China to Malaysia takes 5-7 days versus 14-21 days for sea freight, saving approximately 10-14 days. However, air freight costs RM 15-25 per kg versus RM 2-4 per kg for sea freight. For a typical non-woven tote bag weighing 80g, air freight adds RM 1.20-2.00 per bag to shipping costs—often doubling total landed costs. Air freight makes economic sense only for urgent orders under 1,000 pieces or when late delivery penalties exceed the premium freight cost.
Can I reduce lead time by increasing my order quantity?
Counterintuitively, very large orders (10,000+ pieces) may extend lead time if they exceed a factory's single production run capacity. A factory producing 2,000 bags per day will complete a 5,000-piece order in 3 days but may need 6-7 days for a 15,000-piece order. The "sweet spot" for standard lead times is typically 1,000-5,000 pieces—large enough to prioritize but small enough to complete in a single production cycle.
What happens if I need to change my design after production starts?
Minor changes (logo color adjustment, text correction) can often be accommodated within 2-3 days if caught before printing begins. Structural changes (fabric type, bag dimensions, handle style) require restarting the production process, effectively adding 3-4 weeks to your timeline. The critical cutoff point is material procurement—once fabrics are cut, design changes become prohibitively expensive.
How do Malaysia's plastic bag bans affect supplier lead times?
As Malaysia phases in plastic bag bans (Penang 2025, Perak 2026, national rollout by 2026), demand for reusable bags is surging—straining supplier capacity. We're already observing 1-2 week lead time extensions during peak periods as factories prioritize large government and retail contracts. Businesses should anticipate this trend by securing supplier commitments 8-12 weeks before needed delivery dates.
Should I request samples before placing a bulk order, and how does this affect lead time?
For semi-custom and full custom orders, requesting a pre-production sample is essential—it adds 2-3 weeks to total lead time but prevents costly mistakes. For ready-stock customization, samples are less critical if you've seen physical examples of the base bag and printing quality. The decision rule: if your order value exceeds RM 10,000 or involves untested suppliers, the 2-3 week sample delay is worthwhile insurance.
Next Steps: Planning Your Reusable Bag Order Timeline
Understanding production lead times is the foundation for successful reusable bag procurement, but knowledge alone doesn't prevent delays—disciplined execution does. The businesses that consistently receive on-time, on-spec deliveries share a common practice: they treat lead time as a constraint to plan around, not a variable to negotiate away.
If your organization is preparing to launch a reusable bag program—whether for regulatory compliance with Malaysia's plastic bag bans, corporate sustainability initiatives, or promotional campaigns—the time to begin supplier discussions is now, not when your deadline is 4 weeks away. For guidance on selecting suppliers that match your lead time requirements, quality standards, and budget constraints, explore our Custom Reusable Bags supplier evaluation guide to understand the questions you should ask before committing to an order.
The difference between a successful reusable bag program and a logistical crisis often comes down to a single decision: starting the planning process early enough to absorb inevitable delays without compromising on quality or overpaying for rush services.
You May Also Like

How Last-Minute Packaging Requests Can Consume 30% of Your Corporate Gift Budget
Requesting individual gift boxes after confirming a gift order can increase packaging costs by 30% and extend lead times by 7-10 working days. This article, from a factory project management perspective, analyzes the four hidden costs of late-stage packaging specifications and the varying complexities for different gift bag types (canvas, non-woven, jute).

When Corporate Gift Budgets Collapse at the Last Mile: Malaysia's East-West Delivery Cost Trap
Enterprise procurement teams often finalize gift type selection before mapping delivery geography. In Malaysia, this sequence creates a structural cost problem that only surfaces at the logistics stage—and by then, the budget has already been approved.
